Generate a schedule proposal

Let IoTFlows compute a constraint-aware plan from the work already on the board, then review it before any of it is written.

Resequencing a busy week by hand means holding dependencies, machine availability, shift hours and tool contention in your head at once. The optimizer does that arithmetic and hands you the answer as a preview.

It writes nothing on its own. You get a set of proposed bars and a banner of numbers, and you decide whether the numbers are worth the moves.

Before you start

What Optimize does

A proposal is a computed plan the board shows you but has not saved. The optimizer walks your work orders in dependency order, earliest due date first, and gives each one the earliest slot where its machine, its materials and its predecessors all allow it.

It only ever changes two things on a work order: the due date and the Time Estimate. Quantities, statuses, assignees, dependencies and the machine stay exactly as they are.

Put real Time Estimates on the work before you judge the optimizer. A task with no estimate is drawn as a one-hour bar carrying a ~1h chip, and the plan is only as good as the durations it is given. A board where most bars read ~1h produces a thin proposal, and that is the most common cause of a disappointing first run.

Run it on the whole board

With nothing selected, click Optimize in the Gantt toolbar. The proposal appears immediately, since it is computed in your browser.

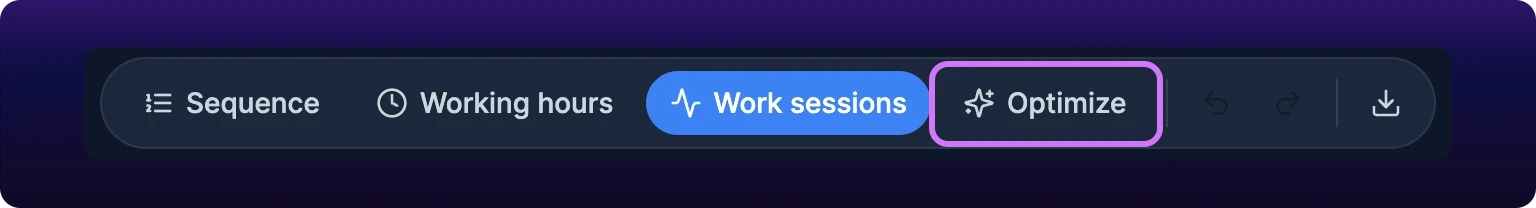

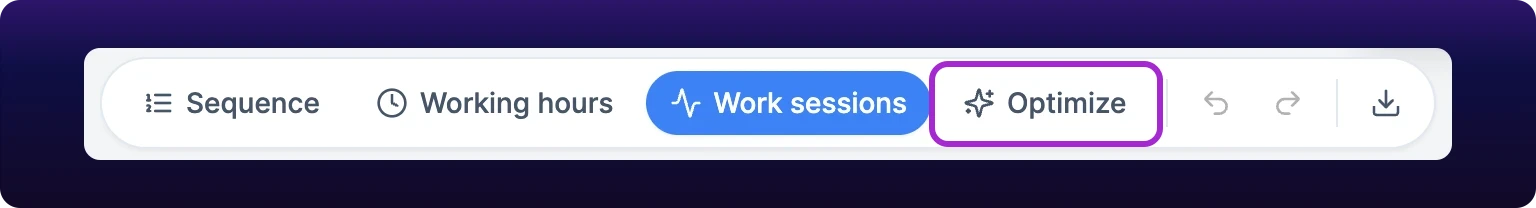

A cropped detail of the left half of the Gantt toolbar. Four pills read Sequence, Working hours, Work sessions and Optimize, the last carrying a sparkle icon and ringed in violet, with undo, redo and download icons past a divider to its right.The Optimize pill in the Gantt toolbar, after Sequence, Working hours and Work sessions. It plans against the Time Estimate on each task, so a task without one is planned as an hour.

Run it on a selection first. A whole-board run on a busy schedule moves work people have already promised to customers, and the fastest way to lose trust in the optimizer is to apply one of those. Optimize only what you selected is the safer first run.

Should Working hours be on? Turn it on before you optimize if the plan has to stay inside shifts. The optimizer reads the same toggle the bars do: with Working hours off it plans straight through nights and weekends, and the proposal will be shorter than anything the floor can deliver. See Turn on Working hours.

Optimize is unavailable in Sequence view, because those bars stand for order rather than time and carry no time axis to move along.

Review the proposal

Every move is drawn as a dashed indigo ghost bar at the proposed time, joined to its live bar by a dotted line, with a chip above it reading how far it shifts: 6h later, 1.2d earlier, or gets scheduled for a task that had no date.

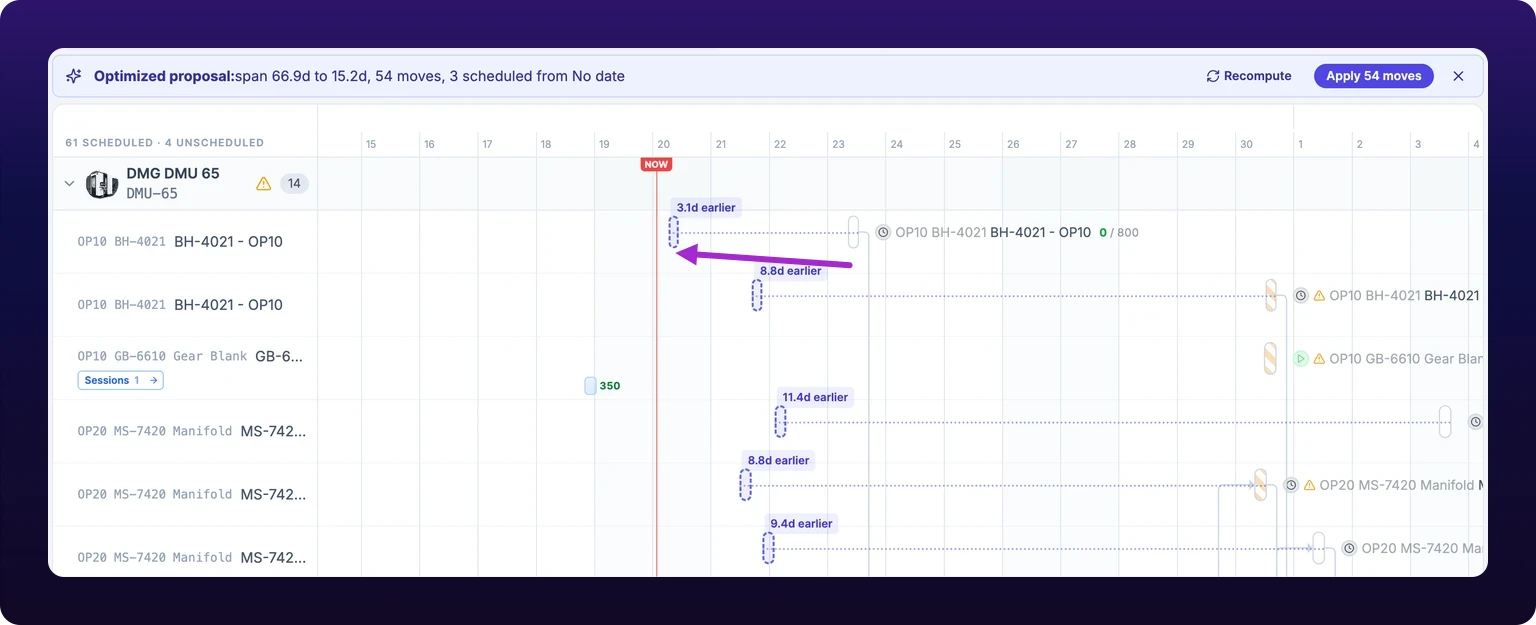

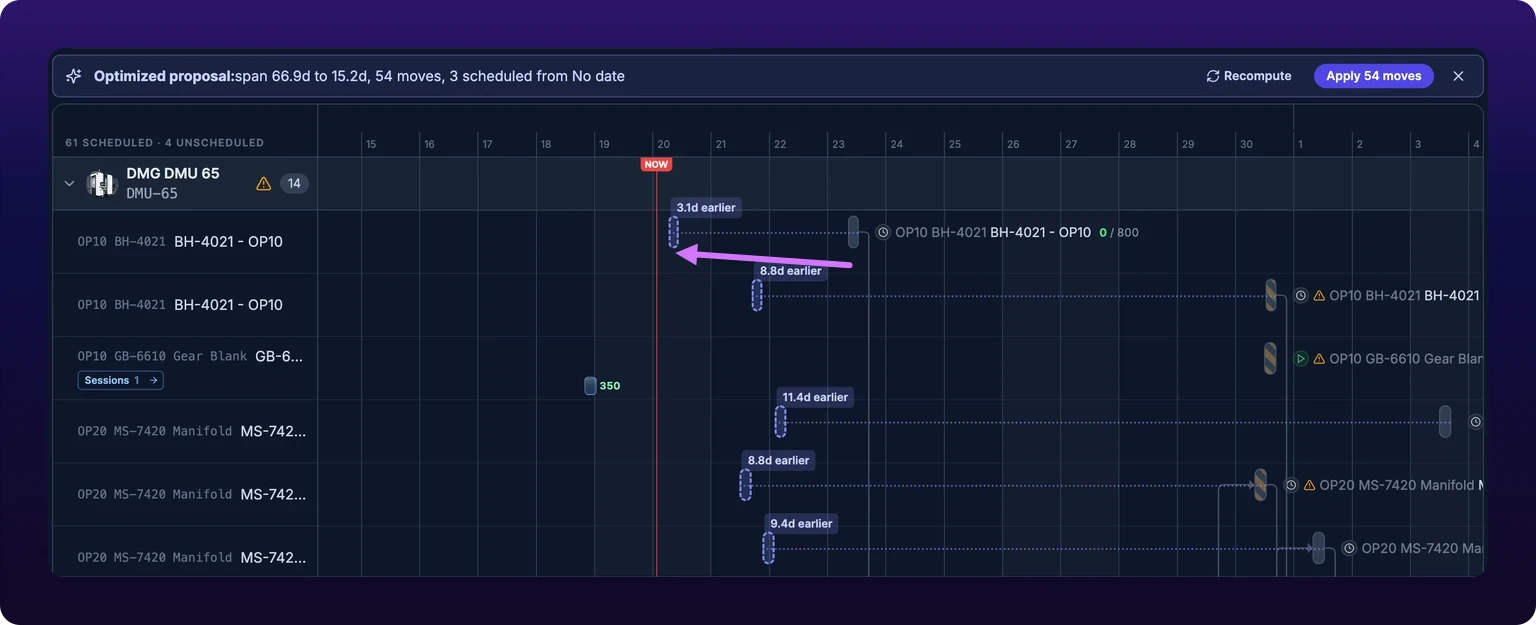

The Gantt with a proposal on screen. An indigo banner reads Optimized proposal: span 66.9d to 15.2d, 54 moves, 3 scheduled from No date, with Recompute, Apply 54 moves and a cross at its right end. Below it six lanes of the DMG DMU 65 group each hold a narrow live bar toward the right of the chart, and well to the left of each sits a dashed indigo ghost bar joined to it by a dotted horizontal line, with a chip above reading 3.1d earlier, 8.8d earlier, 11.4d earlier or 9.4d earlier. A violet arrow runs from the top lane's live bar back to its ghost.An optimizer proposal on the Gantt. Each move it suggests is drawn as a dashed indigo ghost bar, joined to the live bar by a dotted line, and nothing is written until you apply.

You do not need to accept the whole proposal. Click a ghost to skip that one move: it turns gray, takes a skipped label, and Apply relabels itself Apply 12 of 18. Click it again to put the move back.

Skipping is how you protect a job you have already promised without losing the rest of the plan. To protect it permanently, right-click the bar and choose Lock scheduling instead, which takes it out of every future run.

Span is the stretch from the earliest start to the latest finish across the board's scheduled work, written as 66.9d. Lower is better.

The banner above the chart is one sentence of numbers followed by the three actions. It reads, in order: violations before and after, span before and after, the number of moves, and the number of tasks scheduled from No date. Violations only appear when the board has at least one before or after, so a permanent 0 to 0 never sits there.

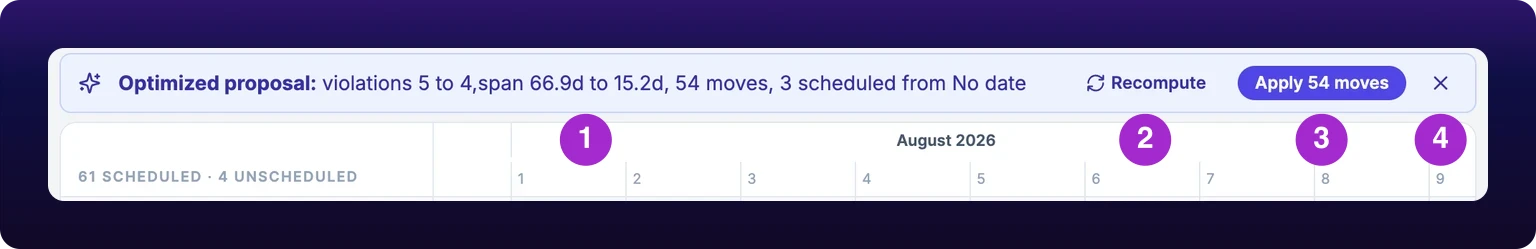

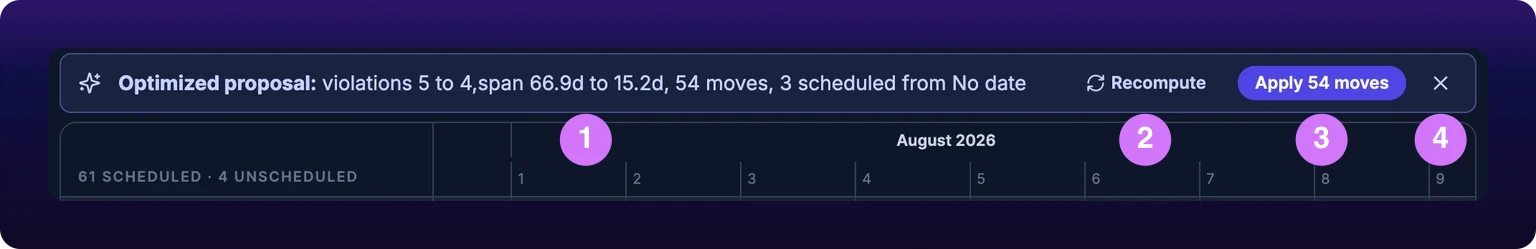

An indigo banner across the top of the Gantt carrying a sparkle icon, with four numbered callouts in the board header immediately beneath it. Callout 1 marks the sentence, which reads Optimized proposal: violations 5 to 4, span 66.9d to 15.2d, 54 moves, 3 scheduled from No date. Callout 2 marks a Recompute button with a refresh icon, callout 3 a filled indigo button reading Apply 54 moves, and callout 4 a small cross at the right end.The proposal banner: one line reading violations and span before and after with the number of moves, then Recompute, Apply and the cross that discards.

If span barely moves and violations do not fall, discard it. Eighteen moves that buy half a day are eighteen conversations you now owe the floor, and a proposal that gains nothing is telling you the schedule was not the problem.

The banner does not report double-booked machines. To see that number change, check the issues pill before and after, or run the optimizer inside a Simulation, whose band carries Double-booked as its own metric.

Proposal actions

ActionEffectUndoable
Click a ghost barSkips that move and dims the ghost. Apply relabels to Apply 12 of 18Nothing is written yet
Apply N movesWrites a due date and a Time Estimate to every included work orderYes, as one step
RecomputeDiscards this proposal and runs the optimizer again over the same scopeNothing is written
The cross at the right endDiscards the proposal and leaves the board as it wasNothing is written
Clicking Optimize againSame as the crossNothing is written
Regrouping the boardClears the proposalNothing is written

Apply the proposal

Apply saves every move you did not skip. Each work order is written on its own, and the whole set lands in the undo history as a single entry, so one Undo puts the schedule back where it was. A run of more than one work order confirms with Apply optimized schedule · 18 work orders.

What does Apply write to a task with no estimate? The one-hour default. A ~1h bar that moves comes back with a real Time Estimate of 60 minutes, which then looks like a number somebody chose. Set the estimates you know before you apply, not after.

If some of those writes fail you get 4 of 18 updates failed, reverted: the four that failed go back to the dates they had, the rest are saved, and the proposal closes either way. Run it again for the ones that did not take.

Inside a Simulation, Apply stages the moves instead of writing them, so they join the draft and wait for Commit. See Run the optimizer inside a Simulation.

Recompute

A proposal goes stale the moment one of the work orders in it changes underneath you, whether you dragged the bar, edited it in the drawer, or a colleague moved it. The banner replaces its numbers with The schedule changed while previewing. Recompute to get a fresh proposal. and Apply is disabled until you do.

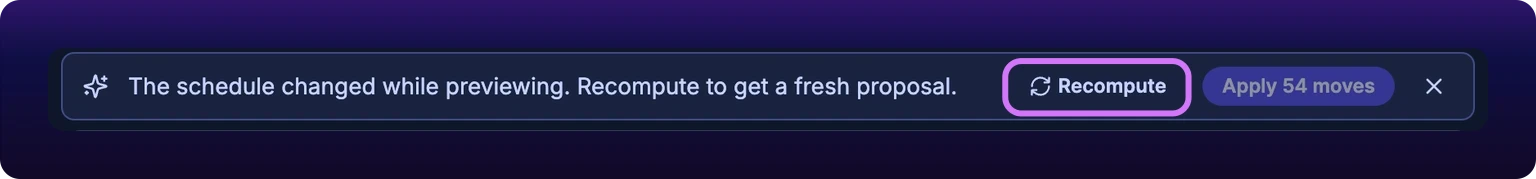

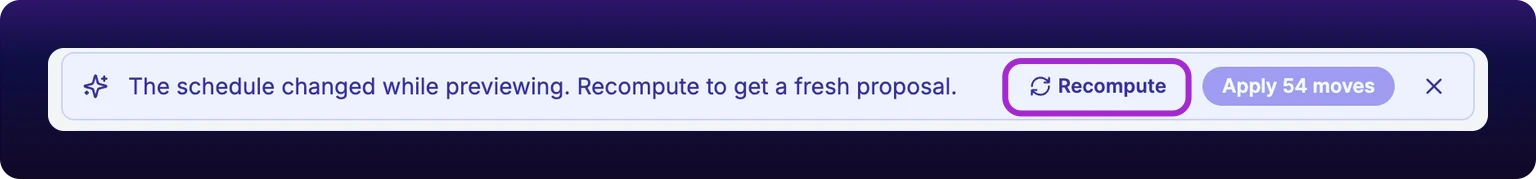

A cropped detail of the indigo proposal banner. Where the sentence of numbers was, it reads The schedule changed while previewing. Recompute to get a fresh proposal. The Recompute button is ringed in violet and the Apply button to its right is dimmed.When a work order in the proposal changes, the banner replaces its numbers with a line saying the schedule changed, and Apply is disabled until you recompute.

Only the due date, machine and duration of a work order the proposal moves are watched. Editing a title, or a bar the proposal left alone, does not flip the banner.

Recompute reruns the optimizer over the same scope the proposal started with, so a scoped run stays scoped. Any ghosts you had skipped come back included.

Discard

Click the cross at the right end of the banner to throw the proposal away. Clicking Optimize again does the same thing, and so does regrouping the board. Nothing was written, so there is nothing to put back.

Optimize only what you selected

A scoped run is a run that may move only the work orders you selected. Select bars first, by dragging a box across the chart, Shift-clicking to add, or holding Ctrl and clicking one bar to take its whole dependency chain. The pill then reads Optimize 5 selected.

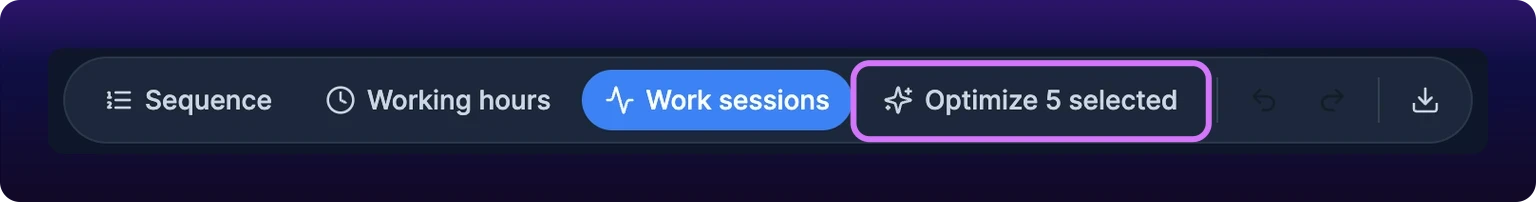

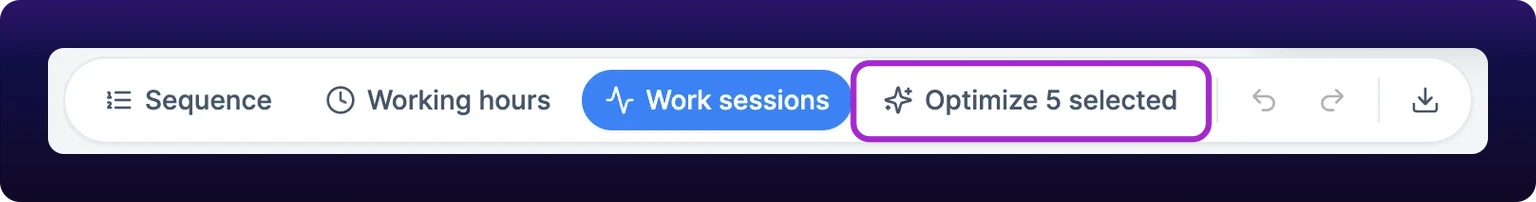

A cropped detail of the Gantt toolbar with bars selected on the board below. The Optimize pill, ringed in violet, has widened to read Optimize 5 selected. To its left sit Sequence and Working hours unfilled and Work sessions filled blue, and to its right the undo, redo and download icons.With bars selected, the pill reads Optimize 5 selected. A scoped run may move only those five work orders and plans them around everything else.

Everything outside the selection is held exactly where it is. It still reserves its machine time and its materials first, so the selection is planned around the untouched work rather than on top of it, and an unselected predecessor still sets the floor for a selected successor.

The banner names the scope: Optimized 5 selected:, then the same numbers. Press Esc to clear the selection when you are done.

Select a rush order and its chain, run it, read the span, and you have asked "how early can this finish without disturbing anything else" and got an answer in one gesture.

What it will not move

Pinned work keeps its dates and its machine and is reserved before anything else is placed. Three things are pinned, always: work that is Completed, work that is In Progress, and work you locked with Lock scheduling on the bar's right-click menu. A locked bar carries a padlock and cannot be dragged by hand either.

Select only pinned work and there is nothing to plan. The board says so rather than opening an empty banner: Nothing to optimize in the selection: those work orders are completed, locked or in progress.

A run that finds no improvement is also a valid answer, not a failure. The banner opens reading 0 moves with Apply disabled, which means the optimizer could not beat the plan you already have.

What it respects

What Optimize respects and what it pins

InputTreated asNotes
Completed, in-progress and locked workPinnedReserved first, then planned around
Everything outside the selection, on a scoped runPinnedSame treatment as completed work, for that run only
DependenciesHard constraintA task starts no earlier than its predecessor finishes, pinned predecessors included
One job at a time per machineHard constraintKeyed to the machine on the work order, so the answer is the same in every grouping
Working hoursRespected when Working hours is onOff, the plan runs through nights and weekends
Setup time on the work orderAdded before the task startsArrives from your ERP import or the API; no dashboard field sets it
A serialized piece or a reusable toolCapacity constraintWork waits for the piece or the tool to come free. See the capacity lane
Demand larger than the shop ownsPlaced anywayNo amount of moving fixes it, so it stays flagged as a violation
NowFloorNothing is planned into the past, so overdue work all comes forward
The machine on the taskUntouchedThe optimizer plans each task on the machine it already has
A task with no due datePulled in when it has a machineIt gets a date and the banner counts it under scheduled from No date

Tasks with no due date and no machine stay in the unscheduled chips down the left of the board. Give one a machine, or drag it onto a date yourself, and the next run will plan it. See Schedule work that has no dates.
